This article outlines the essential protocols and meticulous testing procedures. In this section, you will learn how to maintain accurate and reliable continuous emission monitoring equipment and find valuable insights for certification, recertification, and component replacement.
The purpose of this guide is to explain how Continuous Emission Monitoring Systems (CEMS) are certified and recertified. From the Operational Test Period to meeting performance specifications, the article describes how to ensure emission data is accurate and reliable.
After major component replacements, the person responsible for recertifying must undergo rigorous testing within a certain period of time. As well as minor component replacements, the guide emphasizes quality control checks and recommends regular testing. This resource, taken from Section 5 of the Alberta CEMS Code, is ideal if you want to make sure their continuous emission monitoring systems are accurate.
Certification means proving that the Continuous Emission Monitoring System (CEMS) works as it should.
After installing new continuous emission monitoring equipment, it's a good idea to run it for about a week while the pollution source (like those in a factory) is running. This helps make sure everything is working right before official testing begins.
Certification Requirements:
- You need to test and certify a new CEMS installation or a CEMS that's completely replaced.
- If you only replace some parts, you might not need full certification, just recertification for those parts.
- To get certification, systems have to meet certain performance standards within a specific time frame (either 120 unit operating days or 180 consecutive calendar days, whichever comes first) from when the emissions first go into the air.
- The CEMS needs to be fully operational for at least 168 hours during an Operational Test Period, while the pollution source is running.
Operational Test Period:
- During the Operational Test Period, operators need to run the CEMS normally and follow certain procedures.
- They mustn't do any unplanned maintenance or repairs during this time, except for scheduled checks and tests.
- Calibration and tests might pause for a bit, but only for specific checks, and they have to record when this happens.
- If something doesn't work right during this time, they need to investigate and fix it before continuing.
Additional Tests for Certification:
- The technicians also need tests during the Operational Test Period, including checking how well the CEMS measures gas concentrations, temperature, and flow rates.
- They need to do a calibration drift test, which checks if the measurements stay accurate over time.
- They have to test the system's accuracy and bias.
- If they use a correction factor to make measurements accurate, they have to set it up before certification and use it during testing.
- If the Operational Test Period gets interrupted (like if the factory shuts down), you need to record when it stopped and start it again when the factory restarts.
- If anything goes wrong during the Operational Test Period, figure out why and fix it.
Repeating Tests:
- If a certification test, especially the Relative Accuracy Test Audit (RATA), fails during or after the Operational Test Period, you might have to restart the Operational Test Period and do the test again.
- The results of these tests also count towards meeting future testing requirements.
Director Sign-off and Reporting:
- Once everything is working correctly and meets all the requirements, the CEMS is certified. There's no need for special permission from the director.
- Operators will have to report their findings and test results as per the reporting requirements.
- In a nutshell, this section is all about making sure the pollution monitoring system works correctly and provides accurate data about emissions from industrial sources. It involves lots of testing and checks to ensure everything is in order.
This section is about what to do when you replace big parts of your pollution monitoring system (CEMS) and how to make sure it still works correctly. Temporary replacements or rotations of parts are covered in another section.
When to Test and Recertify:
- Whenever you permanently replace a major part of the CEMS or make any changes that could mess up how it works or the data it gives, you need to do performance tests.
- These tests have to meet certain requirements listed in the table below, or you follow the manufacturer's testing and quality control instructions in your plan (QAP).
- It's up to the person in charge to decide if a change might mess up the CEMS or the data it gives. This table doesn't list every possible change that could cause problems. If there's a failure in the tests after a change, the person in charge needs to figure out when things went wrong (see Section 7.6 of the code).

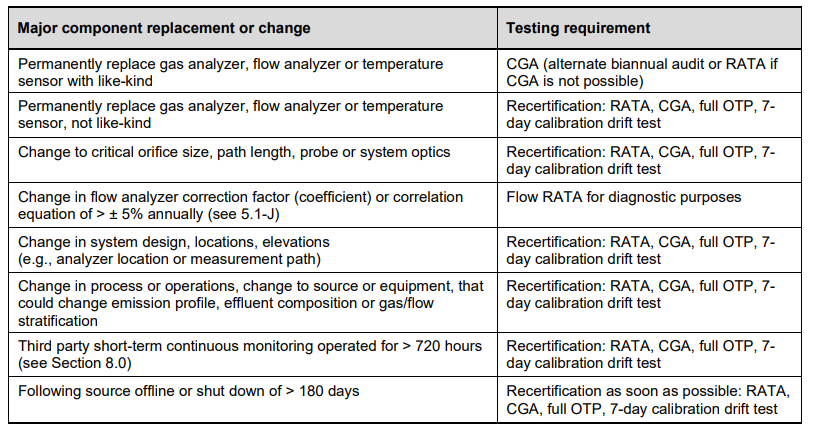

What to Test For:
- The table above has a list of changes and what tests you need to do when you make these changes. For example, if you replace a gas analyzer with a similar one, you need a CGA (Continuous Gas Analyzer) test.
- If you replace a gas analyzer, flow analyzer, or temperature sensor with something different, you need a more comprehensive recertification test, which includes a RATA (Relative Accuracy Test Audit), CGA, full Operational Test Period (OTP), and a 7-day calibration drift test.
- There are other changes listed too, like changing the system's design or the way your factory works. They also need these tests to make sure the CEMS still works correctly.
Recertification Recommended:
- Even if you replace a part with a similar one and don't need recertification, it's still a good idea to do a RATA test after a change.
- The results of tests done for recertification can also count toward meeting future testing requirements (like RATA frequency).
Timing Matters:
- When you make a change and need recertification, you have a maximum of 90 days to complete all the required tests and meet the performance standards.
- Once you successfully meet these requirements, your CEMS is recertified.
Reporting:
- After recertification, you need to let the director know what changes were made and if your monitoring plan changed.
- This should be done within 30 days after recertification.
- In simple terms, this section is all about making sure your pollution monitoring system stays accurate and reliable, even when you replace or change big parts of it. It involves doing certain tests and reporting the results to make sure everything's working as it should.
If you're replacing or repairing small parts of your CEMS, you need to do quality control checks and follow the procedures the manufacturer and your quality assurance plan (QAP) specify. Minor component replacement means you're changing something in the system that shouldn't really mess up how it works or the data it gives.
Quality Control Checks:
- The manufacturer and your QAP will tell you what checks you need to do when replacing or repairing minor components.
- There's a table in Appendix C that gives you some examples of these checks, but it doesn't cover everything. It's up to the person in charge to decide what tests and checks to do and to write them down in the QAP.
Monitoring After Maintenance:
- After you replace or repair something, it's a good idea to keep a close eye on the system to make sure everything's working as it should.
- Even though you don't need to do a full recertification after minor continuous emission monitoring equipment replacement, it's recommended to schedule a regular RATA test shortly after making any changes to the system. This helps ensure your system is still accurate and reliable.
In simple terms, this section is about doing checks and following procedures when you replace, repair, or do maintenance on small parts of your pollution monitoring system to make sure it keeps working correctly. It also suggests doing a test afterward to be extra sure everything's okay.
